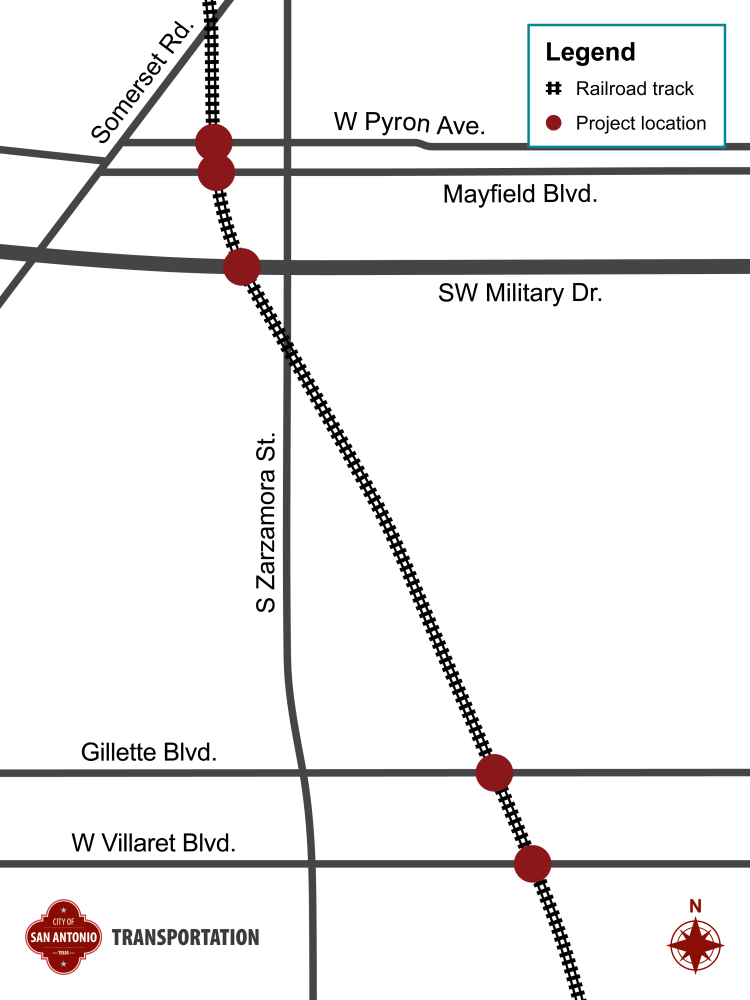

Estimated Construction Timeline

Detours will be required for all crossings:

  • Hutchins: Detour - 1 day for signs and striping and 1 day for concrete/median (2 days)
  • IH-35 WB: Detour – 2 days for signs/striping
  • IH-35 EB: Detour - 1 day for signs/striping

Total working days: 5 days
